Job costing: estimated against actual
Every project page compares its build estimate against the hours and expenses booked to it. Only approved work counts, anything unreviewed is called out separately, and hours are compared as hours because TrailsIQ does not know what anybody is paid.

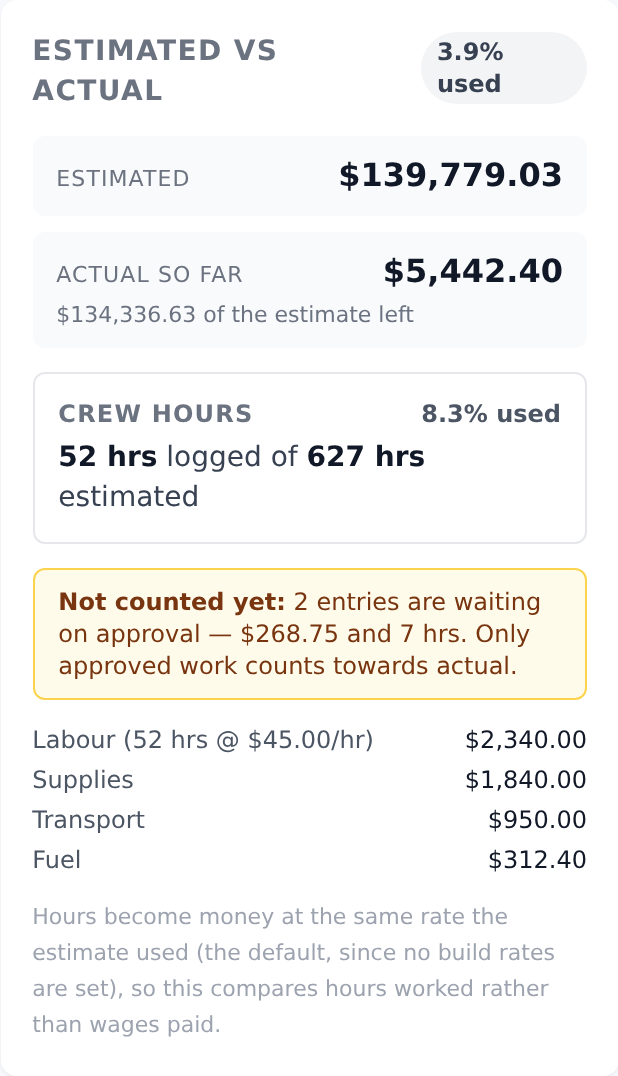

If nobody checks an estimate against what the job really cost, the next estimate is no better. Estimated vs actual sits on every project page and answers one question: is this job costing what we said it would?
It only uses what you already record. Work hours and expenses can be linked to a project (see Work hours and expenses), and this panel adds them up and puts them next to the build estimate.
What counts as actual
Only approved work counts. A draft expense is only a plan, and a submitted one is only a request. Neither counts as a cost until a manager approves it. Rejected entries never count.
Anything waiting for review is listed right under the totals, for example "2 entries are waiting on approval", with the hours and money involved. This matters more than it sounds. A job can look comfortably under budget while three thousand dollars sits unreviewed in the queue, and somebody may make a decision based on that number.
To get work onto a job in the first place, pick the project when you log the hours or submit the expense. Both forms have a link field for it.
Everything is in your organization's currency. An expense filed in a different currency is not added to the total, because adding it would need an exchange rate. The panel lists those expenses under the total instead, so they are not lost.
Reading the numbers
The main figure is the percentage of the estimate used.
We chose that on purpose. Comparing one total against another only means something once the job is finished. Three weeks into a build, "96% under budget" is true, but it really means the work has barely started. The percentage used makes sense at every stage of a job, and once it goes past 100 it shows you the overrun.
Below it, the panel shows how much of the estimate is left. Once you go over, it shows over by in red instead.
The breakdown lists labor on one line and then each expense category, biggest first, so whatever used most of the budget is at the top.

Crew hours give the fairest comparison
TrailsIQ does not know what anybody is paid. So when the panel turns your logged hours into money, it uses the same hourly rate the estimate used. That is the rate in Settings → Trail build rates, or the built-in default if you have not set your own.
Using the same rate on both sides is what makes the comparison fair. It tells you whether the work took the hours you priced it at. It does not tell you what your wages came to, so do not give it to your accountant as a payroll figure.
That makes the Crew hours block the most reliable part of this panel. The estimate counts labor in hours, your crew logs hours, and so the two numbers measure the same thing. If you only look at one row, look at that one.
Materials from inventory are shown at cost, beside the total
Inventory items linked to a project appear under Materials from inventory, with the quantity planned for the job and, once stock has been drawn, the quantity drawn. If an item has a cost per unit, the row shows what that quantity is worth, and the block shows a subtotal.
That subtotal is not added to the actual total above it. Stock was paid for when it was bought, often through an expense that is already counted on this panel. Adding it again would count the same money twice. If you know the stock was bought for another job, or came out of general supplies, you can add the subtotal to the total yourself.
An item with no cost set is listed with its quantity and counted as "no cost set", rather than treated as free. To add a cost, open the item in Inventory and choose Edit.
What this is not
This panel tracks the cost of a job. It is not accounting software. It does not know about overheads, insurance, depreciation on your machine, the time somebody spent quoting, tax, or anything that never became a work-hour entry or an expense claim.
Use it to answer are we on track against what we quoted, and where is the money going? Keep your books wherever you keep them now.
Common gotchas
- An expense is missing. It has no project on it, or it has not been approved. Check the review queue first.
- The panel is not on the project at all. Nothing has been recorded and there is no estimate yet, so there is nothing to compare. It appears as soon as either exists.
- Actual is high but the job feels fine. Look at Crew hours rather than the money. If the hours are on track, the money line is telling you about materials, not labor.
- The rate is wrong. It comes from Settings → Trail build rates. If you have never set them, the panel says so and is using the default.
- Hours logged against a maintenance task do not show. They belong to the task, not the project. Link the hours to the project if they are part of the job.
- The percentage is small on a nearly-finished job. That means the estimate was high, which is worth knowing before you quote the next one the same way.
